Case studies - 31 March 2025

Night demolition of A4 motorway overpass

The project in summary

We worked on the demolition of the Fauglis-Gonars overpass and subsequently disposed of and recovered the demolished materials

Year
2017

Location
Fauglis (UD)

Client
Company specialized in the construction of large-scale works

Gesteco services provided
Demolition
Disposal and recovery of demolished materials
Supply of gravel

Critical issues
Winter night work, with very tight deadlines and several companies involved that had to work in synergy

Completion times
160'

Number of Gesteco operators involved
27

Vehicles used
5 excavators
2 4-axle tractors
1 mechanical shovel
1 Bobcat shovel

Order information

Requirement

The old overpass that connected Torviscosa to Fauglis, on the A4, had to be demolished in one night. Several companies were involved in the execution of the intervention and each had to operate with extremely precise execution times.
The demolished material had to be completely removed and the road surface cleaned to allow the reopening of the motorway the following morning.

Activities carried out

We took care of the demolition of the overpass in synergy with the other companies involved, we laid a non-woven protective fabric on the road surface near the overpass, supplied and laid the gravel needed to prevent the fall of concrete blocks and the consequent damage to the road surface. Finally we removed the demolished materials and sent them for recovery in our plant in Laipacco.

Results

In just 160 minutes we carried out our interventions, also the result of numerous coordination meetings for the synergic management of the various phases of the project. The road system of that stretch of highway was reopened the following morning without any damage to the road surface.

Where we started from

The overpass of the Fauglis-Torviscosa municipal road, built in the 1960s, had restrictions on the transit of vehicles weighing more than 18 tons.

A company specialized in the construction of large-scale works had been awarded the contract for the construction of the third lane Palmanova-Gonars which, among other works, also included the demolition of the overpass. Since we had already collaborated with the aforementioned company in the past, they asked us to carry out, together with other companies, this particular intervention.

The peculiarities of this demolition project

In this project we had to deal with several critical elements:

  • it was a night-time job and to be carried out in the winter season;
  • the execution times were very tight;
  • there were several companies involved that had to work in synergy;
  • there were many men and vehicles in the field at the same time;
  • the materials had to be completely removed and the underlying road surface preserved;
  • the subsequent disposal and partial recovery of the removed materials was required.

Bureaucratic formalities and coordination

To be able to work on this project, it was essential to have the SOA certification for the OG 8 category (River, defense, hydraulic and reclamation works).

Up until then, we had not needed it, but in just 15 days from the start of the process we obtained it, following the entire process with great care and determination. A result that was not to be taken for granted in such a short time.

In addition to this certification, the project required several coordination meetings between managers and operators. There were many variables in play, including 5 large excavators in action at the same time, which had to operate without getting in each other's way.

It was also essential to take into account both the management of motorway and ordinary traffic, and the supervision of the methods of carrying out the works.

Intervening on an interconnection node, where the A4 and A23 cross, required a careful study of traffic flows and the preparation of alternative routes.

The phases of the intervention

Spreading the sand

On December 1, 2017, the day before the intervention, we transported 90 cubic meters of sand taken from our Pradamano treatment plant and positioned it next to the reference area.

At 11:00 p.m. on December 2, the work began with the closure of access to the overpass and the stretch of highway below.

The first operation consisted of positioning 900 square meters of non-woven fabric on the highway road surface. On this, with our mechanical shovels, loaded by excavators, we spread 50 cm of sand whose function was to cushion the blows of the falling parts of the demolished overpass and therefore prevent the road surface from being damaged.

In the meantime, teams of workers removed the guardrails and horizontal signs.

Alternating demolition with excavators and grabs

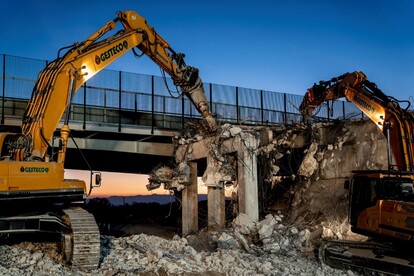

When everything was ready, the work began alternating between the 5 excavators with pneumatic hammers, which made the holes, and the subsequent intervention of the demolition pliers, which crushed the parts just drilled.

The work was spectacular precisely because of the synergy between vehicles and men and the very precise timing.

The cold was making itself felt, but there was no time to waste because at dawn the highway had to be reopened.

The clearing of materials

Once the demolition operations were completed, the removal of the materials began.

First, the demolished bulky elements were removed, then the layer of sand was removed and finally the non-woven fabric. Finally, motor brushes carefully cleaned the road surface.

In addition to the demolition of the overpass, some signage portals and variable message panels were removed, the horizontal signage of the A4/A23 connection ramps at the Palmanova hub was adjusted, and the central guardrail near the demolished overpass was restored.

The reopening of the road network

At 6:00 am on Sunday 3 December, traffic on the A23 motorway was restored, 3 hours ahead of schedule.

The more than 150 people at work, including technicians, workers, assistants, maintenance workers and the Highway Police, were able to breathe a sigh of relief for the great work done. The 27 Gesteco technicians involved also joined in the general satisfaction of all parties involved.

The results obtained

We were able to optimally manage the various elements of complexity of this intervention.
In just 160 minutes we carried out the planned interventions. The road system of that stretch of highway was reopened the following morning without any damage to the road surface.

We also started the recovery of 135 cubic meters of demolition material.
Watch the video which summarizes the main phases of the demolition intervention.

Even in the Fauglis-Gonars overpass demolition project, the principles of sustainability were a guiding factor in our intervention.

At the end of the works, we also took care of the recovery of the demolished material, including the sand used as a base and the removed asphalt.

We took these materials to our plant in Laipacco and recycled them, giving them new life.

The aim of all our interventions is to reduce the amount of waste that ends up in landfills, promoting the recycling and reuse of inert materials through the production of aggregates, and thus contributing to a more sustainable approach to the management of construction and demolition waste.

The images of the project
